Engineering toolkit · Engineering toolkit

BESS QA/QC Toolkit

Make readiness a traceable evidence decision—not a status color.

Templates, controlled JSON policies, passing examples, and Python audits connect requirements, checks, evidence IDs, revisions, owners, deadlines, closeout, and acceptance.

Engineering question

How can project requirements, checks, evidence IDs, revisions, owners, deadlines, and acceptance decisions remain traceable through BESS delivery?

Gate FAT, SAT, commissioning, closeout, document control, calibration traceability, and handover evidence with inspectable policies and scripts.

System and evidence boundary

Evidence control spans the delivery lifecycle.

Each gate leaves project authority with the responsible reviewers while making missing, stale, inconsistent, or unapproved evidence visible.

Delivery lifecycle

  1. 01Supplier reviewRequirements, documents, interfaces
  2. 02FATFactory checks and evidence IDs
  3. 03Shipment + site receiptCondition and controlled records
  4. 04SATSite checks and deviations
  5. 05CommissioningMeasurements + calibrated instruments
  6. 06AcceptancePunch list, residual risk, approvals
  7. 07HandoverControlled revision and signed decision

Traceability graph

  1. 01RequirementAcceptance reference
  2. 02Check / testUnique Check ID
  3. 03Evidence recordUnique Evidence ID + location
  4. 04RevisionSupersession chain
  5. 05ApprovalControlled state
  6. 06Acceptance decisionAuthorized human gate

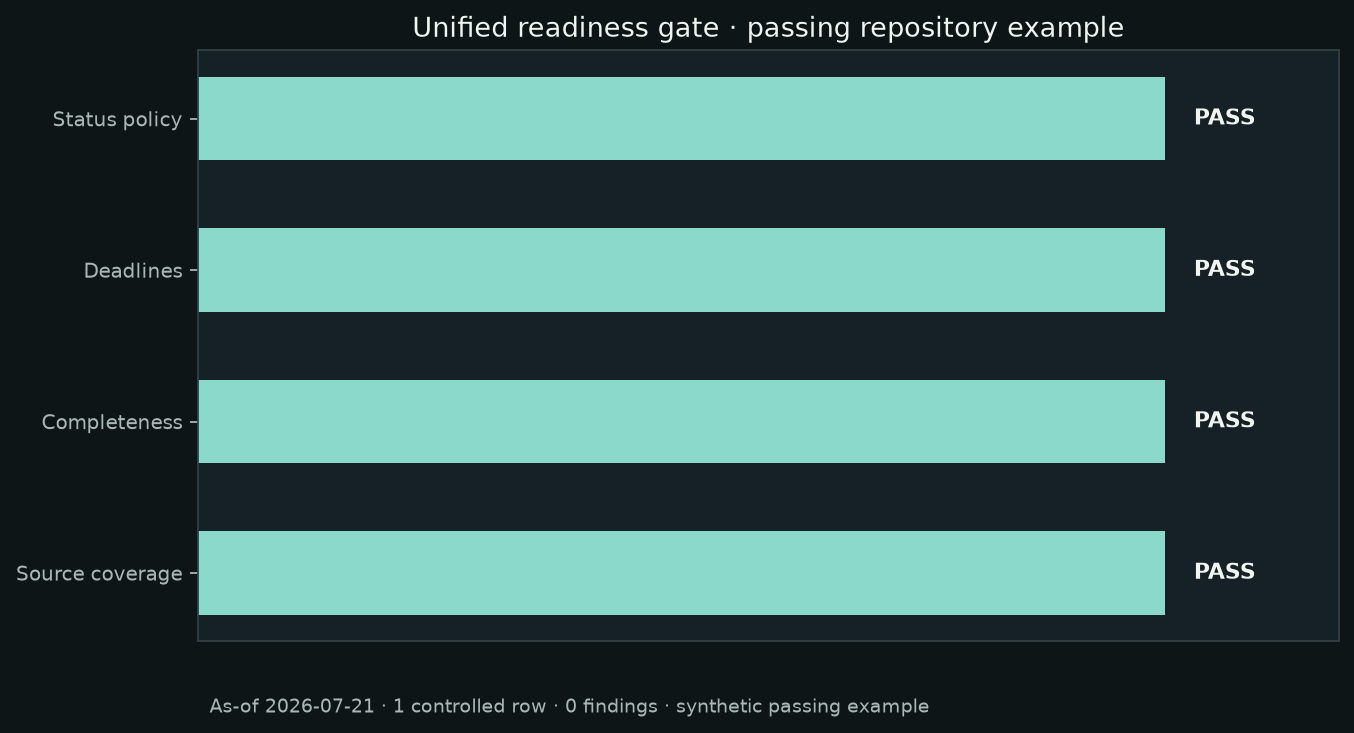

Unified readiness gate

  1. 01Status policyVocabulary + blocking states
  2. 02Deadline auditExplicit as-of date
  3. 03Conditional completenessFields required by workflow state
  4. 04Source coverageEvery controlled file evaluated
  5. 05Pass / findingsMachine-readable report for human review

Verified results

Figures keep scenario, units, source, and evidence class attached.

Every visual below points to its source data or retained source format and to the release- or commit-specific implementation behind it.

Validation and evidence

What passed, what was demonstrated, and what remains unvalidated.

One hundred forty-two tests and four subtests passed across templates, readiness, deadlines, completeness, evidence, calibration, punch-list, document-control, and handover audits.

Template quality

35 Markdown templates passed structural validation for titles, explanatory context, table separators, and column consistency.

Automated suite

142 tests and 4 subtests passed across status, deadlines, completeness, readiness, evidence, calibration, punch-list, document-control, and handover controls.

Passing examples

Repository examples exercise clean commissioning evidence, calibration history, punch-list closeout, document control, readiness, and handover decisions.

Authority boundary

The scripts report controlled findings; they do not approve work, waive a requirement, interpret a contract, or replace an authorized acceptance decision.

Shortest verified path

Pin the audited source before running it.

git clone https://github.com/mohammadrezwankhan/bess-qaqc-toolkit.git
cd bess-qaqc-toolkit
git checkout 61d89bfd1ca49800e786c501dda82ea951b55a01
python -m unittest discover -s tests -v
python scripts/validate_templates.py
python scripts/audit_readiness.py examples/readiness-gate-passing-record.md --status-policy config/readiness-status-policy.example.json --completeness-policy config/readiness-completeness-policy.example.json --as-of 2026-07-21 --require-source-coverage --format json

Verification environment: Python 3.14.6 on Windows 11. Commands are concise entry points; repository documentation remains authoritative for setup details.

Documentation map

Go directly to the useful evidence.

Engineering boundary

The artifact cannot qualify the decision by itself.

Related professional context

Follow the evidence into adjacent work.

Use the pinned source, inspect the evidence, and keep project authority with a qualified human reviewer. Open 61d89bf Return to open engineering
